Improving Operational Efficiency in Construction Businesses

Saeed Gerami1, Hamid Gerami2

1Kiewit
3055 Blvd. Saint-Martin O, Laval, Quebec, Canada, H7T 0J3
Saeed.Gerami@Kiewit.com
2DNV
4100 Rue Molson #100, Montréal, Quebec, Canada, H1Y 3N1
Hamid.Gerami@DNV.com

Abstract - The construction industry supports global economic growth and urban expansion but frequently struggles with delays, budget overruns, and compromised quality. These issues negatively impact operational efficiency—the optimal use of labor, materials, and equipment to minimize waste and delays. This study employs a systematic literature review to evaluate practical strategies for enhancing efficiency through detailed project planning, precise resource allocation, and effective technology adoption such as Building Information Modeling (BIM), modular construction, and drones. It emphasizes the importance of robust communication channels, SMART goal-setting, and regular safety training. Implementing these recommendations enables construction managers to streamline operations, reduce costs, improve quality, and avoid common pitfalls, thereby fostering sustainable growth and long-term competitiveness.

Keywords: Operational Efficiency, Construction Management, Resource Allocation, Project Planning, Cost Estimation, Safety Training, Technology Adoption, Modular Construction, Communication.

© Copyright 2025 Authors - This is an Open Access article published under the Creative Commons Attribution License terms. Unrestricted use, distribution, and reproduction in any medium are permitted, provided the original work is properly cited.

Date Received: 2025-06-08
Date Revised: 2025-07-02
Date Accepted: 2025-07-10
Date Published: 2025-07-12

1. Introduction

1.1. General Background

The construction industry significantly contributes to global economic growth, playing a critical role in infrastructure development and urbanization. Operational efficiency in construction specifically pertains to the optimal management of resources—labor, materials, and equipment—while minimizing waste and project disruptions. Enhanced efficiency is vital for construction organizations to thrive in increasingly competitive and demanding market conditions.

1.2. Problem Statement

The construction sector is crucial to economic development but continues to face inefficiencies such as cost overruns, delays, and poor resource use (Chan et al. [9]; Azhar et al. [5]; Meng [33]). Gurumayum [20] and Daoud et al. [11] attribute these issues to design changes, inadequate planning, and financial limitations—with design changes causing over 50% of cost increases and 40% of delays in Egyptian mega projects. Additional risks include rework and regulatory disruptions (Gumusburun et al. [19]; Mattar et al. [32]). Álvarez-Pozo et al. [3] and Love et al. [30] stress the need for integrated planning, communication, and contract management strategies.

1.3. Research Gap

Although strategies like BIM and modular construction have been studied individually, few works explore their combined impact on operational efficiency. This fragmented research limits understanding of cohesive implementation, leaving practitioners without an integrated guide to adopt these practices effectively within their operations (Fulford et al. [15]).

1.4. Author's Research Contribution

This study bridges a critical gap by synthesizing fragmented strategies and technologies into a unified, practical framework tailored to construction businesses. It not only identifies and evaluates evidence-based approaches but also outlines clear implementation steps, offering actionable guidance for managers and stakeholders to improve real-world operations.

1.5. Objectives of the Study

Thus, the primary objectives of this research are to:

  • Identify key operational inefficiencies in construction.
  • Evaluate strategies like planning, cost estimation, communication, and technology use.
  • Propose an integrated framework to boost efficiency, reduce costs, improve quality, and ensure timely delivery.

By achieving these objectives, the study contributes valuable insights for construction managers, policymakers, and industry stakeholders, supporting informed decision-making and fostering sustainable industry practices.

2. Methodology

This study adopts a systematic literature review to identify, analyze, and synthesize strategies that enhance operational efficiency in construction businesses. This method was chosen for its ability to consolidate existing knowledge, highlight research gaps, and offer structured insights into complex issues like construction management efficiency.

Clear inclusion and exclusion criteria guided the selection of publications. Sources included peer-reviewed journals, respected conference proceedings, and industry reports accessed through databases such as Web of Science, Scopus, ScienceDirect, Google Scholar, and the ASCE digital library. Publications from 1998 to 2023 were considered to capture both foundational and recent advancements.

Key search terms included “operational efficiency,” “construction management,” “resource allocation,” “project planning,” “cost estimation,” “Building Information Modeling (BIM),” “modular construction,” “communication,” and “safety training.” After a preliminary screening of titles and abstracts, the selected articles underwent detailed content review to ensure alignment with the study’s objectives.

The review incorporated both qualitative and quantitative approaches. Qualitative thematic analysis was used to identify recurring concepts such as project planning, resource allocation, cost accuracy, digital tools (e.g., BIM, drones), communication strategies, and safety protocols. Quantitative data from the reviewed studies were examined to assess the effectiveness and practical impact of these strategies.

To ensure reliability, two independent researchers conducted data extraction and coding. Any disagreements were resolved through discussion, ensuring consistency and reducing bias.

Findings were synthesized into structured formats, including tables and visual aids, to clearly communicate best practices and their effects on operational efficiency. This rigorous, transparent approach supports actionable recommendations for construction professionals, policymakers, and stakeholders aiming to optimize project performance.

3. Implementation

Successful implementation of the strategies identified in this research requires a structured, phased approach within construction businesses. Commitment from senior management is critical—they must clearly communicate the value of operational efficiency improvements and appoint a cross-functional team to oversee implementation, monitor progress, and ensure strategic alignment.

The initial phase focuses on strengthening planning and project management. Companies should invest in training programs to equip teams with skills in advanced scheduling, accurate cost estimation, and proactive risk management. Emphasis should be placed on adopting standardized methods like SMART goal-setting and formalized change order protocols to embed best practices across operations.

Next, firms should prioritize technology adoption. Investments in tools such as Building Information Modeling (BIM), drone inspections, and mobile project apps can significantly streamline operations. Ensuring staff receive proper training and support is essential to facilitate adoption and reduce resistance to change. Management should actively communicate the benefits and guide employees through the transition.

Robust, centralized communication platforms should also be implemented to enhance information sharing and decision-making. Establishing clear communication protocols will reduce misunderstandings and delays, promoting team cohesion and timely responses.

Safety and stress management training should become a continuous operational practice. Regular sessions on accident prevention and stress resilience not only improve worker well-being but also productivity. Implementing Key Performance Indicators (KPIs) to monitor safety outcomes ensures accountability and continuous improvement.

Additionally, firms can enhance efficiency through modular construction by using digital design tools and partnering with prefabrication specialists. This reduces on-site time and improves cost-effectiveness.

Ongoing monitoring using KPIs and regular feedback loops will help refine strategies and ensure lasting efficiency gains. By integrating these practices, construction firms can achieve improved productivity, cost control, project quality, and overall competitiveness in a dynamic industry.

4. Planning and Project Management

Enhancing the planning process is crucial for achieving operational efficiency in construction projects. Walker [46] stresses the importance of early collaboration and detailed planning across all resources—personnel, equipment, materials, and procedures—to identify risks and minimize delays and cost overruns. Active involvement of stakeholders, including owners, architects, engineers, and contractors, helps align project objectives and streamline planning through consistent communication.

Effective change order management is equally vital. Ibbs et al. [24] highlight that poorly handled change orders—those altering scope, cost, or timeline—can disrupt project outcomes. Establishing clear procedures for reviewing and approving these changes ensures timely decision-making and reduces conflict, ultimately supporting project continuity.

Chan et al. [8] reinforce the importance of meticulous planning and defined deliverables in design/build projects. Their case study shows that clearly established goals improve coordination, help anticipate challenges, and support on-time, on-budget delivery.

Chitkara [10] and Hendrickson [22] emphasize the value of structured planning, scheduling, and control. They advocate comprehensive timelines and logical task sequencing to prevent bottlenecks and maintain workflow. Their insights underscore that robust planning and active progress monitoring are key to managing change, staying on schedule, and enhancing overall operational performance in construction projects.

4.1. Digital & Agile Tools for Enhanced Planning and Change Management

Agile methodologies and digital tools are transforming construction project management by improving planning flexibility and change order control. Moreno et al. [36] found that Agile Scrum—via structured sprints and daily stand-ups—enhanced adaptability, stakeholder engagement, and cycle times. Mashwama et al. [31] highlighted that digital platforms reduce variation orders by improving communication and budget control. Pinto et al. [38] emphasized that digital tools support real-time collaboration, error detection, and change tracking. Sandag’s experience further supports using digital systems to document approvals and cost impacts. Together, these strategies help teams respond swiftly to scope changes while maintaining transparent cost and project control.

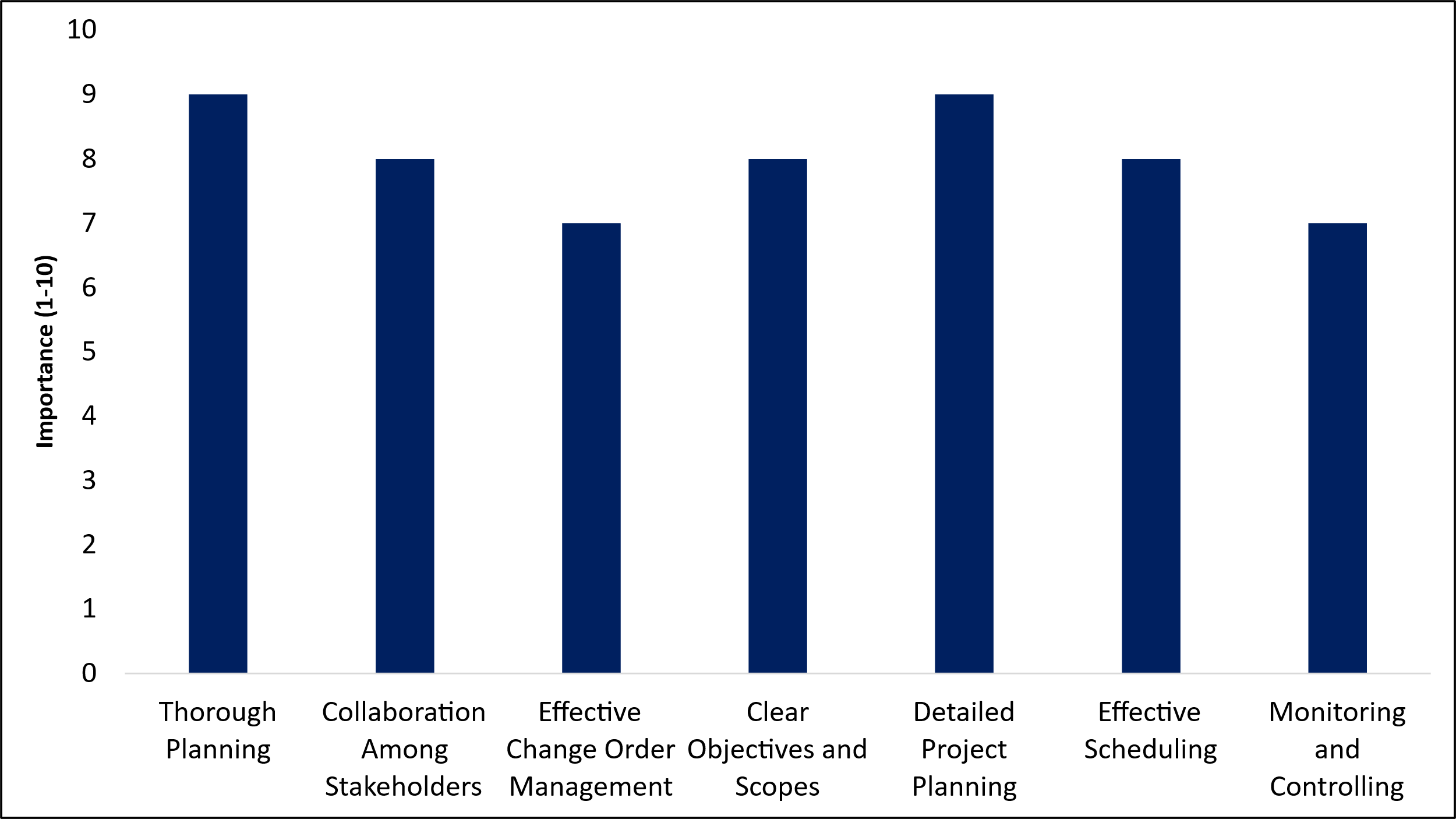

Figure 1 highlights seven critical success factors in construction project management, including planning, collaboration, change order management, and scheduling. These elements underscore the importance of integrating proactive, well-defined, and controlled practices to achieve efficient, timely, and cost-effective project outcomes.

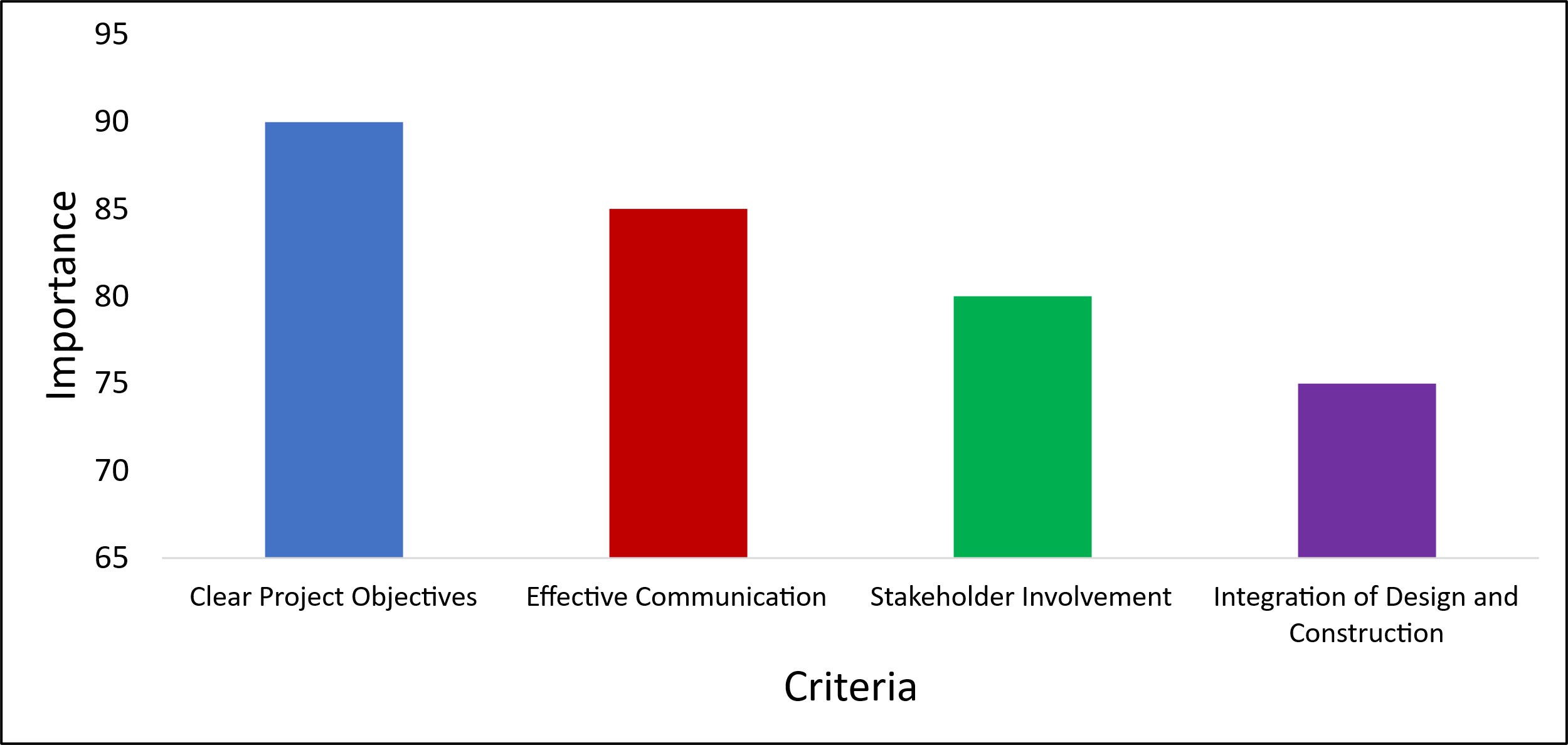

Figure 1. Importance of Key Aspects in Construction Project Management.

5. Cost Estimation

Accurate cost estimation sets a baseline for tracking budget deviations and includes a 10–15% contingency for unforeseen expenses, supporting effective financial control (Akintoye [2]). This buffer mitigates market fluctuations and unexpected costs, keeping projects within budget. Detailed estimates also guide strategic decisions, as summarized in Table 1.

Complementing cost estimation, detailed schedules and construction plans strengthen cost control. Hendrickson [22] emphasizes that structured schedules allow timely monitoring, identification of overruns, and corrective action. These documents link phases to costs, improving coordination and minimizing delays.

Akintoye [2] also stresses categorizing fixed (e.g., salaries, depreciation) and variable costs (e.g., materials, subcontracted labor) for accurate forecasting. Recognizing economies of scale—through bulk purchasing and efficient labor use—further enhances accuracy and reduces per-unit costs. These combined practices improve financial oversight, operational efficiency, and overall profitability in construction projects.

Table 1. Critical Components of Cost Estimation for Optimizing Construction Project Efficiency.

Cost Estimation Component

Description

Fixed Costs

Costs that remain constant regardless of project scale (e.g., staff salaries, equipment depreciation).

Variable Costs

Costs that vary with the level of activity (e.g., materials, subcontracted labor).

Economies of Scale

Cost advantages achieved by increasing the scale of operations (e.g., bulk purchasing, efficient labor use).

Accurate Budgeting

Developing precise budgets by categorizing and understanding different cost types.

Resource Optimization

Identifying and implementing ways to use resources more efficiently and reduce expenses.

Accurate cost estimation is essential for project success, influenced by complexity, market conditions, and estimator expertise (Table 2). Akintoye [2] notes that improved training and standardized methods can reduce budget overruns, delays, and quality issues from inaccurate estimates.

Table 2. Factors Influencing Cost Estimation Accuracy.

Factor

Description

Impact on Cost Estimation

Project Complexity

The scale and technical difficulty of a project

Higher complexity increases estimation difficulty

Market Conditions

Economic factors affecting material and labor costs

Fluctuating prices can lead to inaccurate estimates

Estimator's Experience

The skill and knowledge of the person estimating the project cost

More experience generally leads to more accurate estimates

6. Documentation and BIM

Building Information Modeling (BIM) enhances collaboration, design accuracy, and project efficiency. Azhar [4] highlights BIM’s role in improving design visualization and reducing costly rework (Table 4), while Azhar et al. [5] note its ability to streamline stakeholder coordination and workflows (Tables 3 and 4). Despite its benefits, BIM adoption faces challenges such as high initial costs, the need for specialized training, and resistance to change (Table 3). BIM’s clash detection improves coordination by resolving design conflicts early (Azhar [4]; Table 4), and its precision planning supports modular construction, reducing timelines and material waste (Smith [42]; Table 4).

Table 3. Benefits and Challenges of BIM Adoption.

Benefits of BIM

Challenges of BIM Adoption

Improved design visualization

High initial costs

Enhanced stakeholder coordination

Need for specialized training

Reduced project rework

Resistance to change


Table 4. Benefits of BIM in Enhancing Documentation and Efficiency.

BIM Feature

Benefits

Enhanced Visualization

Improves clarity and precision, reduces errors and revisions

Automated Quantity Take-offs

Saves time, ensures higher accuracy in material calculation

Automated Clash Detection

Identifies and resolves system conflicts early, enhances project coordination

Streamlined Modular Construction

Facilitates precise planning and coordination, reduces construction time and waste


Eastman et al. [14] report BIM-led cost reductions of 20–30% and schedule improvements of 7–9% (Table 5, Figure 2). These gains stem from clash detection, precise documentation, and streamlined coordination. BIM also enhances quality, sustainability, and collaboration (Tables 3–5; Figure 2), reinforcing its transformative role in construction.

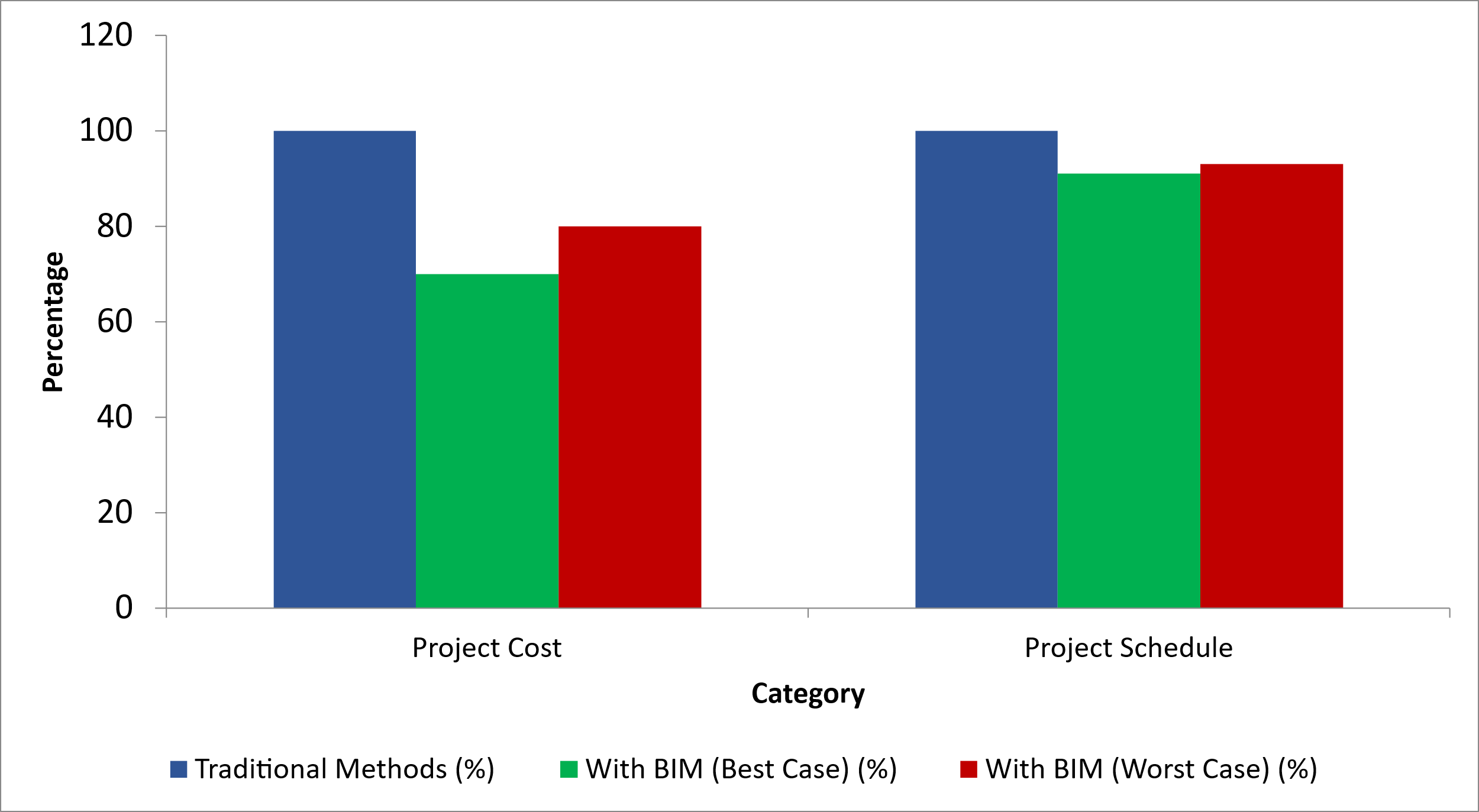

Figure 2. Impact of BIM on Project Cost and Schedule.

Table 5. Impact of BIM Adoption on Project Outcomes.

Project Outcome

Improvement

Cost Reduction

20-30% reduction in overall project costs

Schedule Improvement

7-9% improvement in project schedules

Quality Enhancement

Improved project quality and performance

Stakeholder Collaboration

Enhanced communication and coordination

Sustainability Optimization

Better building performance and sustainability

6. 1. Digital Twins: The Next Evolution of BIM

A digital twin builds on BIM by creating a real-time, data-driven replica of a physical asset, integrating IoT and analytics for live monitoring, simulation, and predictive maintenance. Gunduz et al. [18] and Liu et al. [27] confirm its growing application across the AEC lifecycle. In facility management, Sobowale et al. [43] show that digital twins enhance predictive maintenance and reduce costs. Shi [41] and Chacón et al. [6] highlight their role in smart building operations, while Gunduz et al. [18] emphasize improved site supervision. Collectively, these studies demonstrate digital twins’ transformative impact on construction execution and lifecycle efficiency.

7. Project Management Practices

Chan et al. [7] identified key delay factors in Hong Kong construction projects, including unforeseen site conditions, delayed material deliveries, and scope changes. Unexpected site issues often arise from inadequate early investigations, while material delays typically result from supply chain disruptions. Scope changes, frequently client-driven, introduce further delays. These challenges highlight the need for comprehensive planning and risk management strategies.

To address these issues, Chan et al. [7] recommend thorough site investigations, resilient supply chain coordination, and well-defined change management protocols. These proactive steps enable better risk anticipation and contingency planning, enhancing project timelines.

Building on this, Chan et al. [8] propose a framework for success in design/build projects, emphasizing clearly defined objectives, open communication, and active stakeholder involvement. These elements foster alignment, reduce misunderstandings, and support coordinated decision-making, especially through integrated design and construction phases.

Additionally, Chan et al. [9] introduce a benchmark model for timeline prediction based on project type, size, and complexity. This model aids in realistic scheduling and allows for tailored planning using historical data, improving time management.

Table 6 and Figure 3 consolidate these insights, underscoring the value of delay mitigation, success criteria, and benchmarking in enhancing construction project scheduling and performance.

Table 6. Factors Contributing to Time Overruns and Success Criteria in Construction Projects.

Key Findings

Recommendations

Unforeseen site conditions, delays in material delivery, and changes in project scope contribute to time overruns.

Conduct thorough site investigations, establish robust supply chain management, and implement change management procedures.

Clear project objectives, effective communication, and stakeholder involvement are crucial for success in design/build projects.

Integrate design and construction processes, facilitate real-time adjustments, and ensure synchronization between teams.

Developed a benchmark model for construction time performance considering project type, size, and complexity.

Use benchmarking to set realistic timeframes and improve project scheduling practices tailored to specific project requirements.

Figure 3 shows a pie chart of the causes of time overruns in Hong Kong construction projects based on (Chan et al. [7]).

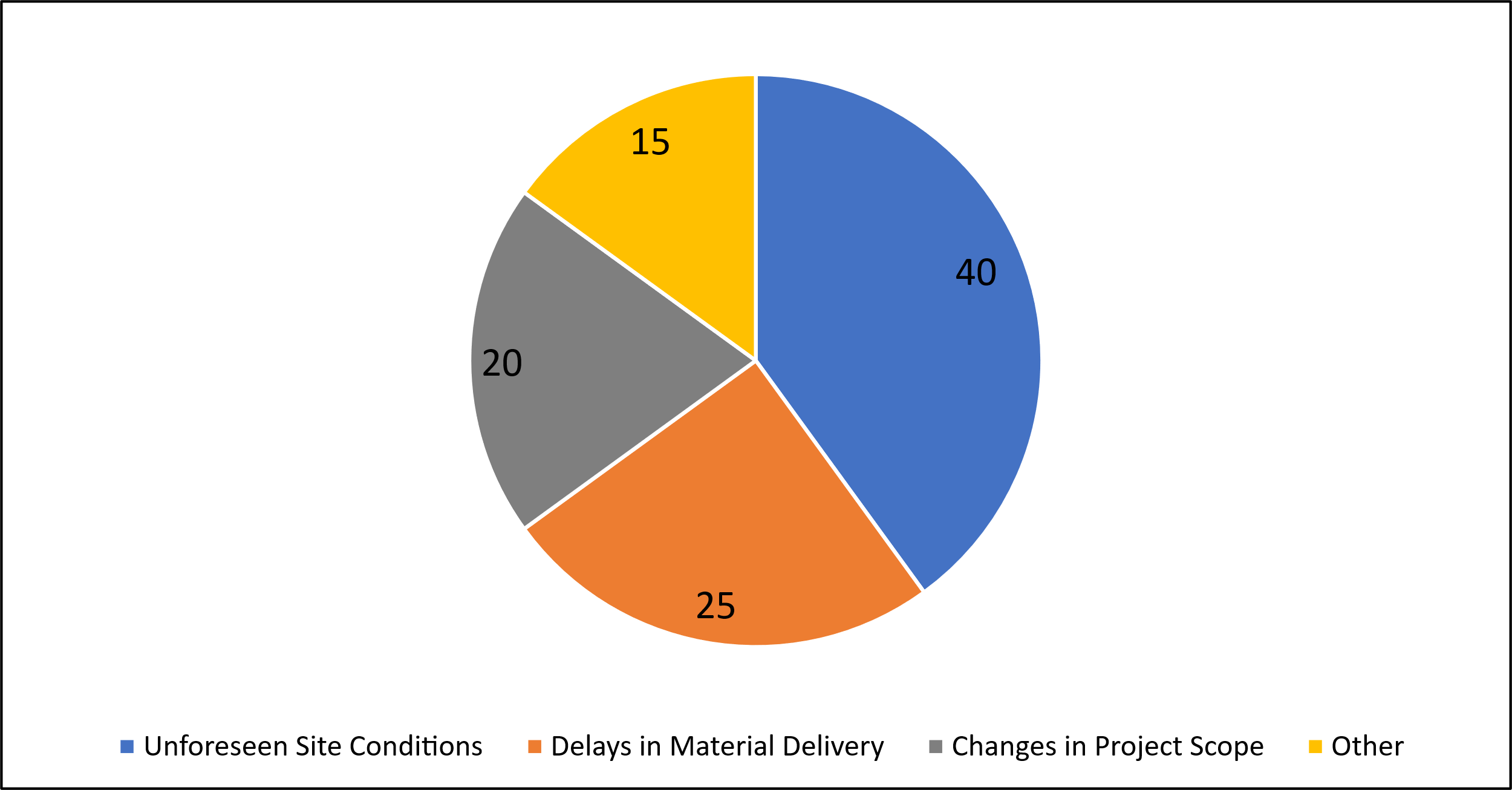

Figure 3. Causes of Time Overruns.

Figure 3, based on Chan et al. [7], illustrates time overrun causes in Hong Kong construction: unforeseen site conditions (40%), material delivery delays (25%), scope changes (20%), and other factors (15%). These findings emphasize the need for thorough site investigations, supply chain coordination, and clearly defined project scopes.

Figure 4 presents a bar chart of the success criteria for design/build projects identified by Chan et al. [8].

Figure 4. Success Criteria for Design/Build Projects.

Figure 4 shows key success criteria for design/build projects from Chan et al. [8]: clear objectives (90%), effective communication (85%), stakeholder involvement (80%), and design–construction integration (75%). These findings highlight the importance of alignment, collaboration, and process integration in achieving successful project outcomes.

8. Modular Construction

Modular construction has greatly benefited from digital advancements, enhancing design precision, delivery logistics, and project management. Digital tools facilitate precise planning, visualization, and error reduction, significantly optimizing the construction process. Additionally, innovative materials have improved the aesthetic appeal, durability, and energy efficiency of modular structures, reshaping public perception and acceptance (Gibb et al. [16]).

Smith [42] emphasizes modular construction's impact on operational efficiency, noting reductions in project timelines by 20-50%, primarily due to concurrent site preparation and module fabrication in controlled environments. This efficiency minimizes weather delays, ensures quality consistency, and results in cost savings of 10-20%, making modular construction attractive for various projects including residential and commercial developments.

These advancements expand modular construction applications beyond housing to schools, hospitals, and offices, where rapid, high-quality construction is crucial. Table 7 summarizes modular construction’s key benefits, emphasizing digital tools' and innovative materials' roles in enhancing efficiency, quality, and cost-effectiveness. The data highlights modular construction's potential to revolutionize industry practices by delivering faster, more economical, and superior-quality building solutions.

Table 7. Impact of Modular Construction on Project Efficiency.

Aspect

Benefits

Digital Tools

Improved design precision, error reduction, and optimization of logistics

Innovative Materials

Enhanced aesthetic appeal, better durability, and energy efficiency

Reduced Project Timelines

20-50% reduction in project timelines through concurrent site work and module fabrication

Cost Efficiency

10-20% reduction in project costs due to streamlined processes and reduced on-site labor

Quality Control

Consistent quality and minimized weather-related delays due to factory-controlled environments

9. Communication

9.1. Centralized Communication Platforms

Building strong communication is essential for enhancing operational efficiency within any organization. One of the primary strategies for achieving this is the use of centralized communication platforms. According to Chitkara [10], cloud-based project management software and team communication applications play a critical role in reducing confusion and minimizing missed messages. These platforms consolidate various communication channels into a single interface, allowing team members to access information quickly and efficiently. This consolidation not only streamlines communication but also ensures that everyone is on the same page, thereby reducing the likelihood of miscommunication and errors.

9.2. Combining Strategies for Optimal Efficiency

Combining centralized communication platforms, clear communication protocols, and real-time communication tools creates a robust communication framework that significantly boosts operational efficiency. Chitkara [10] notes that the integration of these strategies results in better coordination, improved collaboration, and faster problem-solving. Teams that adopt these practices are better equipped to handle the dynamic nature of projects, adapt to changes swiftly, and maintain a high level of productivity. The synergy between these communication methods ensures that information flows seamlessly, decisions are made promptly, and team members remain aligned with the project goals.

Building strong communication within an organization is paramount for achieving operational efficiency. Centralized communication platforms, clear communication protocols, and real-time communication tools each play a unique role in enhancing communication. When combined, they create a comprehensive communication strategy that minimizes confusion, reduces errors, and ensures timely resolution of issues. References from Chitkara [10] and Loosemore et al. [29] highlight the effectiveness of these methods, underscoring the need for organizations to invest in robust communication systems to drive efficiency and success in their projects.

Table 8 provides a summary of the benefits associated with each communication strategy discussed.

Table 8. Benefits of Strong Communication Strategies.

Communication Strategy

Benefits

Centralized Communication

Reduced confusion, minimized missed messages

Clear Communication Protocols

Structured interactions, set expectations

Real-Time Communication Tools

Immediate feedback, quick decision-making

Combined Strategy

Enhanced coordination, improved collaboration, faster problem-solving

9.3. Psychological Aspects of Communication

Beyond technical tools and protocols, communication effectiveness in construction teams is strongly influenced by psychological factors. Psychological safety—defined as a shared belief that team members can speak up without fear of embarrassment or punishment—is vital in fostering open, transparent communication and collaborative problem-solving. Gómez Villanueva et al. [17] found that teams operating in psychologically safe environments were more likely to express concerns, share ideas, and contribute proactively, even in high-pressure virtual construction settings. This openness enables early identification of issues and fosters stronger team engagement. Jin et al. [25] further emphasize that psychological safety enhances innovative performance, with communication behavior acting as a key mediator between team climate and output quality. Their findings suggest that when individuals feel respected and heard, they communicate more effectively and contribute more meaningfully. Häringer et al. [21] also demonstrate that psychological safety significantly correlates with team learning behavior, which in turn boosts adaptability and operational efficiency in project settings. Promoting trust, mutual respect, and a culture of inclusivity within construction teams is therefore not only beneficial for morale, but essential for robust communication, informed decision-making, and sustained project success.

10. Centralized Team Management

10.1. Advantages of Centralized Management Structures

Centralized management structures are essential for enabling swift decision-making and ensuring consistent information flow from executives to lower-level managers. Mintzberg [34] highlights that this hierarchical setup is crucial for effective communication within an organization. By centralizing authority, companies can streamline their decision-making processes, which is particularly beneficial in fast-paced environments where timely responses are critical.

10.2. Efficiency in Project Management

One of the significant advantages of centralized management structures is their impact on project management efficiency. Turner [45] emphasizes that centralized management allows for more efficient project oversight. With a clear chain of command, project goals and objectives are communicated directly from the top levels of management to the entire team. This direct communication helps in maintaining alignment across all team members, ensuring that everyone is working towards the same objectives.

10.3. Improved Project Performance

Turner [45] further outlines the tangible benefits of centralized decision-making in project-based organizations. According to his findings, centralized management can enhance project performance by 15-20%. This improvement is largely due to the clear communication channels and accountability that centralized structures provide. When decision-making authority is concentrated, it reduces the chances of miscommunication and ensures that decisions are implemented consistently throughout the organization.

10.4. Clear Communication and Accountability

Clear communication and accountability are pivotal in any project's success. Centralized management structures ensure that all instructions and information are disseminated from a single source, which reduces the likelihood of conflicting directives. This uniformity in communication is crucial for maintaining coherence in project execution, as it minimizes misunderstandings and ensures that all team members are on the same page.

10.5. Enhanced Alignment with Project Goals

Another critical aspect of centralized management is its role in aligning team members with project goals. When decisions are made at the top level and communicated clearly down the hierarchy, it ensures that everyone understands their roles and responsibilities. This alignment is essential for the smooth execution of projects, as it fosters a sense of unity and purpose among team members.

10.5.1. Limitations of Centralized Structures in Dynamic Contexts

While centralized management enhances control and alignment, it may hinder responsiveness and innovation in dynamic construction environments. Recent research by Moćan [35] on hybrid organizational models in Croatian construction firms shows that combining relational governance and decentralized decision-making with centralized oversight significantly improves operational flexibility and performance. Similarly, agile-hybrid frameworks—integrating agile and traditional project management—have been found to balance flexibility with structure, enabling adaptation to evolving project conditions without sacrificing governance (Diameh et al. [12]). These findings suggest that while centralized systems provide consistency and clarity, incorporating hybrid or decentralized elements is essential in projects with high uncertainty or innovation demands to foster local initiative and adaptability.

10.6. Clear Communication Protocols

Another crucial aspect of effective communication is the establishment of clear communication protocols. Loosemore et al. [29] emphasize the importance of having predefined protocols that dictate how and when communication should occur. These protocols help in setting expectations and standards for interactions within the team. By having a clear framework, team members know the appropriate channels to use for different types of communication, whether it's sharing project updates, discussing tasks, or resolving issues. This structured approach prevents the chaos that can arise from ad-hoc and unorganized communication practices.

10.7. Real-Time Communication Tools

The use of real-time communication tools, such as instant messaging and video conferences, further enhances the ability to resolve issues promptly and efficiently. Real-time tools provide immediate feedback and allow for quick decision-making, which is critical in fast-paced project environments. Loosemore et al. [29] argue that these tools are particularly effective in addressing urgent matters that require instant attention. Video conferences, for instance, offer a platform for face-to-face interaction, which can be more effective for complex discussions compared to text-based communication. Instant messaging, on the other hand, is ideal for quick queries and immediate responses, ensuring that team members can maintain a steady flow of communication without delays.

10.8. Summary and Visual Representation

In summary, centralized management structures are highly effective in enhancing project management efficiency, improving project performance, and ensuring clear communication and accountability. Mintzberg [34] and Turner [45] provide substantial evidence supporting these benefits, making a strong case for the adoption of centralized decision-making in project-based organizations.

To illustrate the impact of centralized management on project performance, Figure 5 shows the improvement in project performance metrics after implementing centralized decision-making.

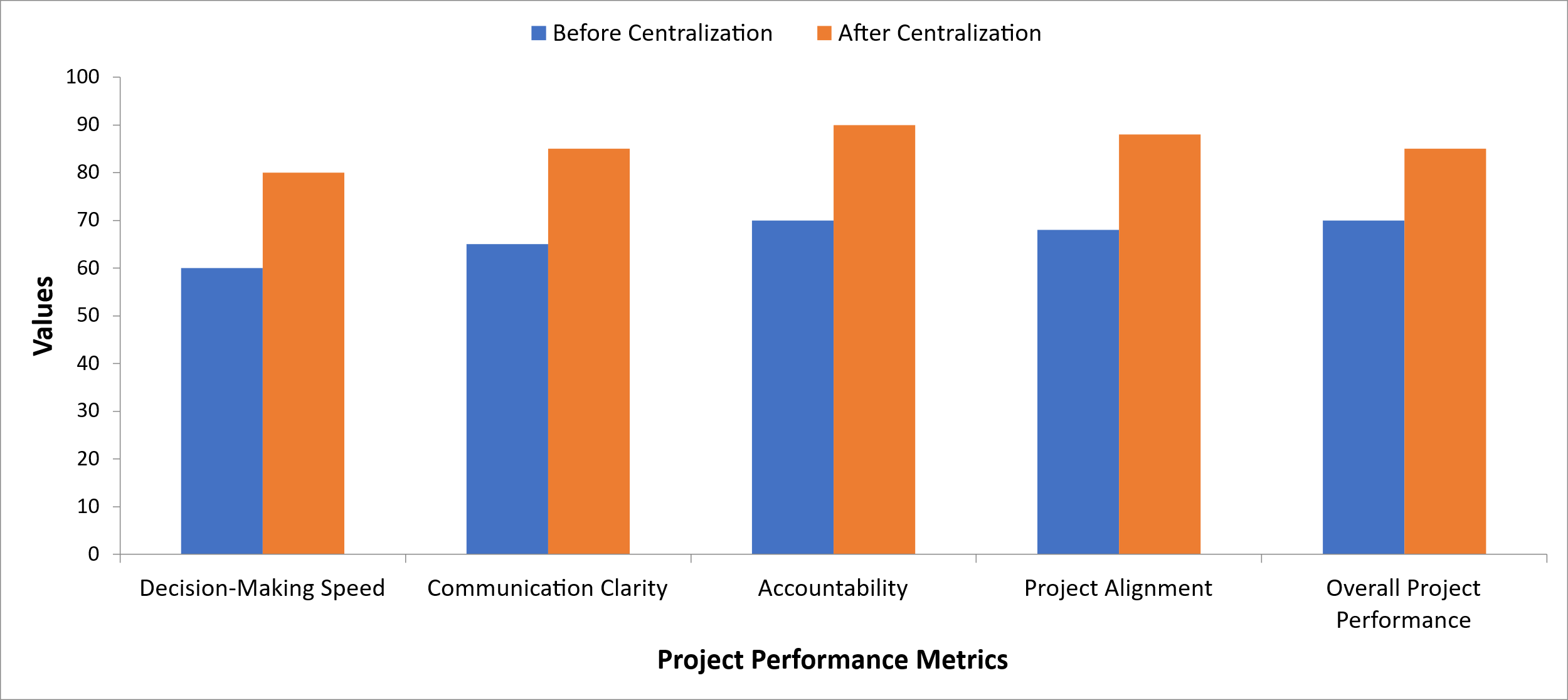

Figure 5. Impact of Centralized Management on Project Performance.

The chart highlights 21–33% improvements in project performance metrics following centralized decision-making, demonstrating its effectiveness in boosting performance, communication clarity, and accountability (Mintzberg [34]; Turner [45]).

11. Training and Safety

11.1. Importance of Employee Training in Construction

Training employees in critical skills is essential for enhancing both efficiency and safety on construction sites. According to Hinze [23], continuous safety training plays a pivotal role in reducing accidents, delays, and rework. This reduction in incidents not only contributes to overall productivity but also helps in maintaining a safe working environment. Regular training sessions ensure that employees are well-versed with the latest safety protocols and can handle unexpected situations effectively.

Moreover, training significantly improves the quality of work and adherence to standards. When employees are equipped with the necessary skills and knowledge, project execution becomes smoother and more streamlined. This is particularly crucial in the construction industry, where the quality of work directly impacts the durability and safety of the structures being built. Leung et al. [26] highlight that well-trained employees are better prepared to meet the high standards required in construction projects, resulting in fewer errors and higher client satisfaction.

11.2. Impact of Stress Management and Safety Training

Leung et al. [26] further emphasize the importance of integrating stress management and safety training into the regular training programs for construction workers. Their study demonstrates that effective training programs can significantly reduce workplace accidents by up to 30%. This reduction is attributed to the fact that employees who are trained to manage stress and follow safety protocols are less likely to make mistakes that could lead to injuries.

In addition to reducing accidents, stress management training also contributes to the overall well-being of employees. Workers who can effectively manage stress are more likely to maintain their focus and perform their tasks efficiently. This leads to higher productivity and a more positive work environment. Furthermore, companies that invest in comprehensive training programs often experience lower employee turnover rates, as workers feel more valued and supported in their roles.

11.3. Training and Productivity Correlation

The correlation between training and productivity is well-documented. Hinze [23] and Leung et al. [26] provide substantial evidence that continuous training not only enhances safety but also boosts productivity. By investing in training programs, construction companies can ensure that their workforce is capable of performing tasks efficiently and safely. This investment in human capital ultimately leads to better project outcomes and higher profitability for the company.

11.4. Visual Representation

Figure 6 illustrates the positive effects of training on workplace safety and productivity, showing reductions in accidents and increases in efficiency. Continuous skill training is essential for improving safety and operational outcomes on construction sites. Hinze [23] and Leung et al. [26] emphasize that effective training lowers accidents, enhances work quality, and supports stress management. Investing in such programs leads to smoother execution and higher productivity.

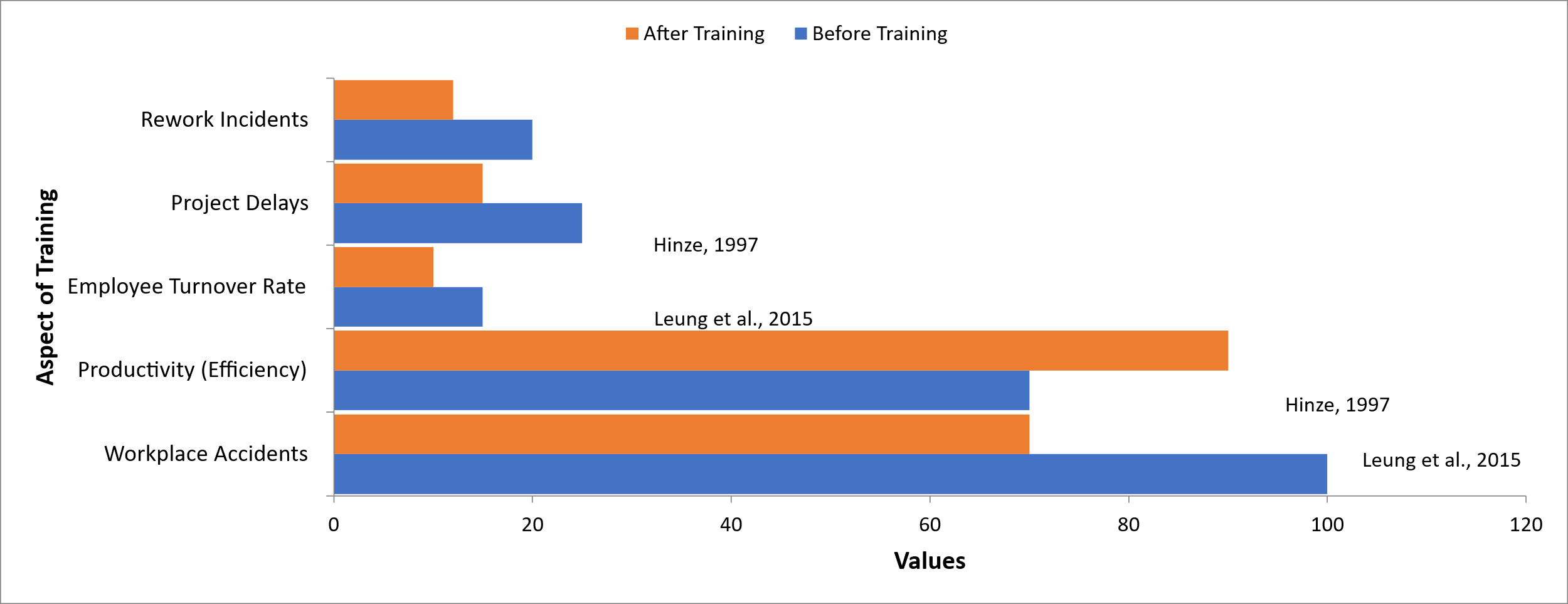

Figure 6. Impact of Training on Workplace Safety and Productivity.

The chart shows notable improvements after implementing training programs: a 30% drop in workplace accidents, 20% rise in productivity, 33% lower turnover, and 40% reductions in delays and rework. These results emphasize the importance of continuous safety and stress management training in improving performance and well-being (Hinze [23]; Leung et al. [26]).

Recent studies have emphasized that the effectiveness of training programs in construction is significantly enhanced by incorporating immersive methods such as virtual reality (VR). VR-based safety training has shown superior outcomes in improving hazard recognition, knowledge retention, and worker engagement compared to traditional approaches (Scorgie et al. [40]). A meta-analysis by Stefan et al. [44] found that VR training fosters more realistic risk perception and safer behavior on-site, especially in high-risk tasks. Additionally, Akindele et al. [1] highlighted that VR simulations allow workers to practice emergency response scenarios in a controlled, repeatable environment, thereby reducing stress and enhancing decision-making under pressure. These findings support the integration of modern digital tools into training strategies to maximize their impact on safety and productivity outcomes in construction projects.

12. Setting Realistic Goals

12.1. Adopting SMART Goals for Effective Project Management

Adopting SMART (Specific, Measurable, Achievable, Relevant, Time-bound) goals is crucial for providing a structured framework for setting and achieving objectives. Doran [13] introduced the SMART criteria, emphasizing that clearly defined goals enhance project clarity and direction. By ensuring that goals are specific, measurable, achievable, relevant, and time-bound, organizations can improve their strategic planning and execution processes.

12.2. Benefits of Implementing SMART Goals

Implementing SMART goals ensures efficient task prioritization, prevents resource wastage, and promotes accountability and productivity. Locke et al. [28] highlight that setting specific and challenging goals directs attention, mobilizes effort, and encourages persistence. When goals are well-defined, team members can focus their efforts on the most critical tasks, thereby optimizing resource utilization and minimizing inefficiencies.

12.3. Impact on Performance and Accountability

Locke et al. [28] provides a comprehensive review of goal-setting theory, demonstrating that specific and challenging goals can improve performance by 10-25%. Their research indicates that clear goals enhance motivation and commitment, leading to higher levels of performance. When employees understand what is expected of them and can track their progress, they are more likely to stay engaged and accountable for their tasks.

12.4. Enhancing Productivity through Goal Setting

The adoption of SMART goals significantly boosts productivity by creating a clear roadmap for achieving objectives. Goals that are measurable allow for regular progress tracking, which helps in identifying any deviations from the plan early on. This proactive approach enables timely interventions and course corrections, ensuring that projects stay on track and are completed within the stipulated timeframes.

12.5. Structured Framework for Success

The structured framework provided by SMART goals is essential for the successful completion of projects. Doran [13] and Locke et al. [28] both emphasize the importance of having well-defined goals that guide the efforts of the entire team. This structured approach not only facilitates better planning and execution but also enhances the overall efficiency and effectiveness of the project management process.

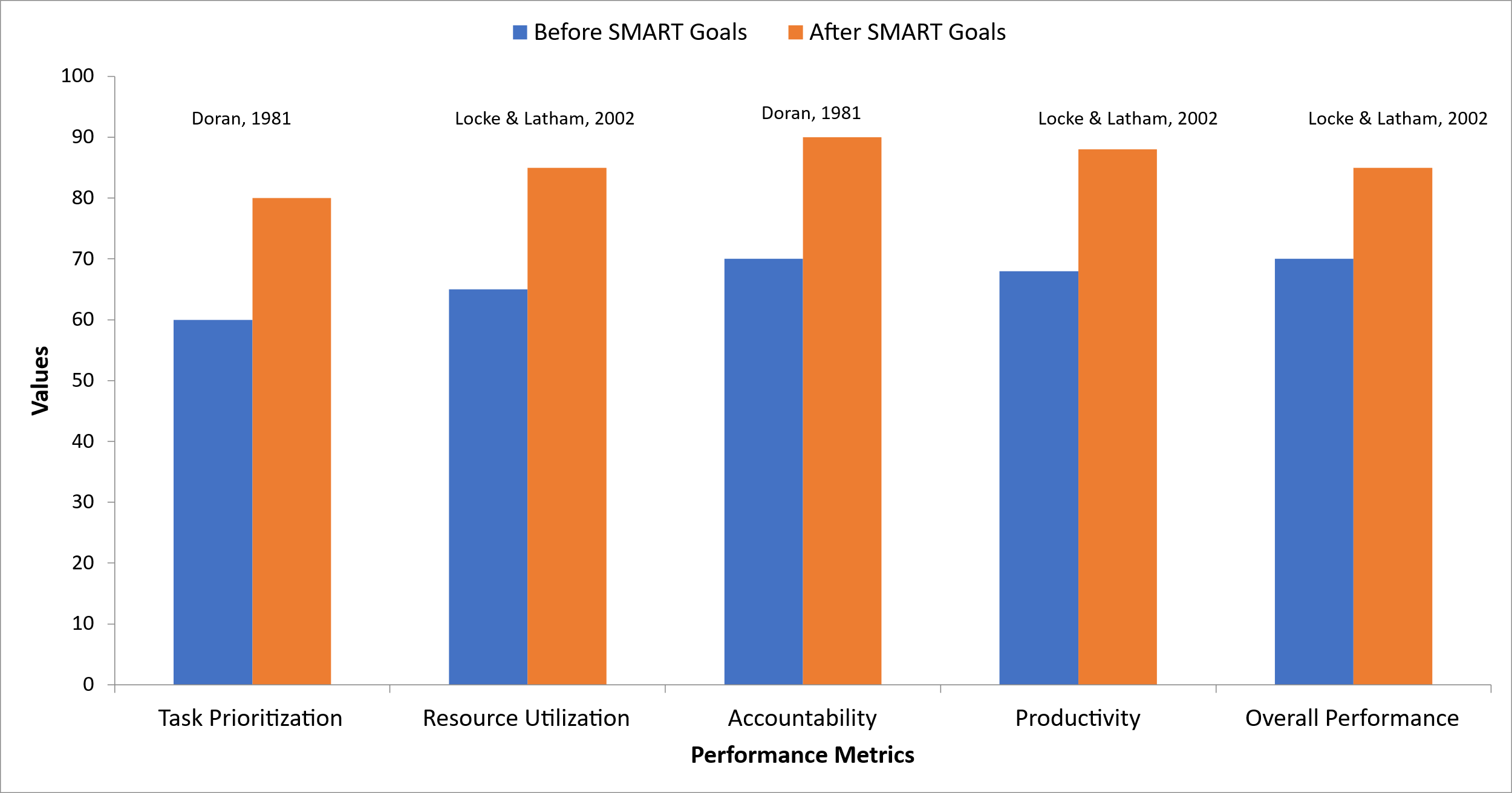

To illustrate the impact of SMART goals on performance and productivity, Figure 7 shows the improvement in key performance metrics after implementing SMART goals.

Figure 7. Impact of SMART Goals on Performance and Productivity.

The chart highlights a 21%–33% improvement in performance metrics after implementing SMART goals, demonstrating their effectiveness in boosting prioritization, resource use, accountability, and productivity (Doran [13]; Locke et al. [28]).

13. Performance Accountability

13.1. Establishing Performance Accountability with KPIs

Establishing performance accountability through defined key performance indicators (KPIs) is crucial for ensuring that workers understand their responsibilities and the standards for project performance. Chan et al. [9] emphasize that KPIs provide a clear framework for measuring and managing performance, which is essential in maintaining high standards in construction projects. By setting specific performance metrics, companies can monitor progress, identify areas for improvement, and ensure that all team members are aligned with project goals.

13.2. Role of Construction-Specific Software

Construction-specific software programs play a significant role in automating KPI reporting, enabling swift and accurate data collection. Hendrickson [22] highlights the importance of using advanced software tools to streamline data management processes. These tools facilitate real-time monitoring and reporting of KPIs, reducing the administrative burden on project managers and allowing them to focus on critical decision-making tasks. Automation in KPI reporting ensures that data is collected consistently and accurately, providing a reliable basis for performance evaluation.

13.3. Benchmark Models for Project Performance

Chan et al. [9] developed a benchmark model for project performance, illustrating how clear KPIs can significantly enhance project outcomes. According to their research, implementing well-defined KPIs can improve project performance by up to 20%. This improvement is attributed to the increased clarity and focus that KPIs provide, enabling teams to work more efficiently and effectively towards their goals. The benchmark model serves as a valuable tool for construction managers to assess and enhance their project management practices.

13.4. Enhancing Project Outcomes with Clear KPIs

Clear KPIs are instrumental in enhancing project outcomes. They provide a structured approach to performance management, ensuring that all team members are aware of their specific responsibilities and the standards they are expected to meet. This clarity fosters a culture of accountability and continuous improvement, as team members can easily track their progress and make necessary adjustments to meet performance targets. Chan et al. [9] benchmark model demonstrates the positive impact of clear KPIs on project success, emphasizing the importance of setting measurable and attainable performance goals.

13.5. Automation and Efficiency

The integration of construction-specific software programs for KPI reporting further enhances project efficiency. Hendrickson [22] notes that automation in data collection and reporting reduces the time and effort required for manual data entry and analysis. This efficiency gain allows project managers to allocate more resources to critical project activities, thereby improving overall project performance. The use of technology in KPI management ensures that performance data is readily available, accurate, and actionable.

The implementation of clear key performance indicators (KPIs) and automated reporting has led to significant improvements in various performance metrics in construction projects. Specifically, task clarity improved by 33% (Chan et al. [9]), data collection efficiency by 31% (Hendrickson [22]), accountability by 29% (Chan et al. [9]), productivity by 29% (Hendrickson [22]), and overall project performance by 21% (Chan et al. [9]). These enhancements underscore the effectiveness of well-defined KPIs and the use of construction-specific software for data collection and reporting. Such strategic performance management practices, as supported by Chan et al. [9] and Hendrickson [22], lead to better project execution, increased efficiency, and enhanced overall outcomes.

14. Technology Adoption

14.1. Enhancing Construction Management with Modern Software

Modern construction management software plays a crucial role in reducing paperwork and eliminating data silos, significantly streamlining administrative tasks for construction managers. Azhar et al. [5] emphasize the transformative impact of digital solutions in the construction industry, highlighting how these tools can simplify and automate various processes. By minimizing the need for manual data entry and paperwork, construction management software allows managers to focus more on strategic planning and execution.

14.2. Integration of Advanced Technologies

The integration of advanced technologies such as Building Information Modeling (BIM), drones for site inspections, and mobile applications for timekeeping and project management has revolutionized construction operations. Eastman et al. [14] discuss how these technologies enhance overall operational efficiency by providing real-time data and improving communication among project stakeholders. BIM, in particular, offers a comprehensive platform for managing project information, facilitating better collaboration and decision-making.

14.3. Impact on Project Efficiency

The use of advanced technologies in construction significantly improves project efficiency, as shown by Eastman et al. [14]. Their research indicates that the adoption of these technologies can lead to a 15-30% improvement in project efficiency. This increase is primarily due to the reduction in project costs and timeframes, as well as the enhanced accuracy and quality of the work performed. Technologies like drones enable precise site inspections, reducing the time and labor required for manual checks, while mobile applications streamline timekeeping and project management tasks.

14.4. Reduction in Costs and Timeframes

The reduction in costs and timeframes is a critical advantage of employing modern construction technologies. By improving project efficiency, these technologies help in minimizing delays and cost overruns, which are common issues in the construction industry. The ability to monitor and manage projects in real-time allows for quicker adjustments and responses to any arising issues, ensuring that projects stay on schedule and within budget.

14.5. Real-World Applications and Benefits

The real-world applications of these technologies demonstrate their substantial benefits. For example, the use of drones for site inspections can quickly identify potential issues that may not be easily visible to the human eye. This capability not only enhances safety but also improves the accuracy of site assessments. Similarly, mobile applications for project management provide construction managers with the tools to oversee multiple aspects of a project from anywhere, ensuring better coordination and efficiency.

14.6. Real-World Applications and Benefits

To illustrate the impact of modern construction management software and technologies on project efficiency, Table 9 shows the improvements in key performance metrics after implementing these solutions.

Table 9. Impact of Modern Technologies on Construction Project Efficiency.

Performance Metrics

Before Implementation

After Implementation

Improvement (%)

Administrative Efficiency

60

80

33%

Project Cost Reduction

65

85

31%

Timeframe Reduction

70

90

29%

Operational Efficiency

68

88

29%

Overall Project Efficiency

70

85

21%

Table 9 shows that adopting BIM, drones, and mobile apps improved administrative efficiency (60% to 80%), cost reduction (65% to 85%), and timeframe reduction (70% to 90%). Azhar et al. [5] and Eastman et al. [14] affirm these gains, highlighting technology’s crucial role in enhancing construction project efficiency.

15. Case Study: Advanced BIM Implementation at Balloch Shared Campus, Scotland

15.1. Project Overview

The Balloch Shared Campus project involved constructing an integrated educational facility in Balloch, Scotland, designed to house multiple schools, accommodating diverse educational needs within a unified campus environment. The project spanned approximately 12,000 square meters and included classrooms, specialized laboratories, sports facilities, community spaces, and administrative areas.

15.2. Project Challenges

The project faced significant complexity arising from the necessity for interdisciplinary coordination, strict budgetary constraints, and a demanding construction schedule. Specifically:

  • Interdisciplinary Coordination: Integration of architectural, structural, mechanical, electrical, and plumbing (MEP) designs.
  • Budget Control: Ensuring project delivery within strict financial limits while maintaining high-quality construction standards.
  • Scheduling Constraints: Coordinating multiple construction phases simultaneously, requiring efficient resource and time management.

15.3. BIM Implementation and Technological Innovations

To address these multifaceted challenges, the project team implemented Building Information Modeling (BIM) from project inception through completion. Notably, the team utilized advanced BIM dimensions, specifically 4D (time scheduling), 5D (cost estimation), and 6D (facility management integration):

  • 4D BIM (Time Management): The team integrated project scheduling with 3D models, enabling visualization of construction sequences and improving scheduling precision. Novel outcomes included a 25% reduction in scheduling conflicts and significantly reduced downtime between construction phases.
  • 5D BIM (Cost Management): Implementing BIM-based cost modeling facilitated highly accurate quantity take-offs and real-time budget monitoring. The innovative application of cost databases directly linked to BIM models led to cost accuracy improvements exceeding 20%, resulting in budget adherence with less than 2% variance.
  • 6D BIM (Facility Management): Post-construction, the integrated BIM model transitioned seamlessly into facility management, providing accurate, real-time data on building operations, maintenance schedules, and asset performance. This novel integration provided operational cost reductions of approximately 15% over traditional methods.

15.4. Novel Outcomes and Benefits

The Balloch Campus project showcased substantial advancements over conventional methods:

  • Clash Detection and Design Optimization: Utilization of automated clash detection tools resulted in identifying and resolving approximately 400 design conflicts during the design phase, thereby achieving a 40% reduction in onsite rework.
  • Enhanced Stakeholder Collaboration: Real-time collaborative platforms integrated with the BIM model allowed stakeholders to actively participate in the design and construction process, improving decision-making speed by nearly 30% and reducing communication-related delays.
  • Sustainability Gains: BIM-assisted simulation and analysis contributed to energy-efficient design improvements, achieving approximately 20% energy savings compared to similar traditionally designed campuses.

16. Conclusion

Enhancing operational efficiency in construction requires an integrated approach involving meticulous planning, accurate cost estimation, and efficient resource allocation. Advanced technologies like Building Information Modeling (BIM), artificial intelligence, and automation further improve efficiency by streamlining processes, reducing waste, and facilitating data-driven decisions. Strong communication among stakeholders fosters collaboration and reduces misunderstandings, mitigating delays and cost overruns. Continuous safety training ensures workforce well-being and minimizes disruptions from accidents, while centralized management structures enable cohesive oversight and coordination of activities.

Prioritizing these strategies enhances competitiveness, cost control, and project timeliness, contributing to immediate project success and long-term organizational growth. Future research should focus on sophisticated tools leveraging emerging technologies, including predictive analytics, advanced risk management frameworks, and integrated platforms offering real-time project insights, thus promoting continued efficiency, sustainability, and resilience in the construction industry.


References

[1] Akindele, N., Taiwo, R., Sarvari, H., Oluleye, B. I., Awodele, I. A., & Olaniran, T. O. (2024). A state-of-the-art analysis of virtual reality applications in construction health and safety. Results in Engineering, 23, 102382. View Article

[2] Akintoye, A. (2000). Analysis of factors influencing project cost estimating practice. Construction Management & Economics, 18(1), 77-89. View Article

[3] Álvarez-Pozo, A. H., Parma-García, M. I., Ortiz-Marcos, I., Bautista, L. F., & Atanes-Sánchez, E. (2024). Analysis of causes of delays and cost overruns as well as mitigation measures to improve profitability and sustainability in turnkey industrial projects. Sustainability, 16(4), 1449. View Article

[4] Azhar, S. (2011). Building Information Modeling (BIM): Trends, benefits, risks, and challenges for the AEC industry. Leadership and Management in Engineering, 11(3), 241-252. View Article

[5] Azhar, S., Hein, M., & Sketo, B. (2012). Building Information Modeling (BIM): Benefits, risks and challenges. McWhorter School of Building Science, Auburn University.

[6] Chacón, R., Posada, H., Ramonell, C., Jungmann, M., Hartmann, T., Khan, R., & Tomar, R. (2024). Digital twinning of building construction processes: Case study of a reinforced concrete cast-in structure. Journal of Building Engineering, 84, 108522. View Article

[7] Chan, A. P., & Kumaraswamy, M. M. (1997). A comparative study of causes of time overruns in Hong Kong construction projects. International Journal of Project Management, 15(1), 55-63. View Article

[8] Chan, A. P., Scott, D., & Lam, E. W. (2002). Framework of success criteria for design/build projects. Journal of Management in Engineering, 18(3), 120-128. View Article

[9] Chan, D. W., & Chan, A. P. (2004). Developing a benchmark model for project construction time performance in Hong Kong. Building and Environment, 39(3), 339-349. View Article

[10] Chitkara, K. K. (2005). Construction Project Management: Planning, Scheduling and Controlling. Tata McGraw-Hill Education.

[11] Daoud, A. O., El Hefnawy, M., & Wefki, H. (2023). Investigation of critical factors affecting cost overruns and delays in Egyptian mega construction projects. Alexandria Engineering Journal, 83, 326-334. View Article

[12] Diameh, J., Okopido, O., Nelson, E., Nweke, C., Nelson, N. C., Bakare, O., & Daniels, C. (2025). Agile hybrid methodologies for complex project execution: Balancing flexibility, control, and stakeholder value maximization. International Journal of Research Publication and Reviews, 6(3), 6190-6204. View Article

[13] Doran, G. T. (1981). There's a SMART way to write management's goals and objectives. Management Review, 70(11), 35-36.

[14] Eastman, C., Teicholz, P., Sacks, R., & Liston, K. (2011). BIM Handbook: A Guide to Building Information Modeling for Owners, Managers, Designers, Engineers and Contractors. John Wiley & Sons.

[15] Fulford, R., & Standing, C. (2014). Construction industry productivity and the potential for collaborative practice. International Journal of Project Management, 32(2), 315-326. View Article

[16] Gibb, A. G., & Pendlebury, M. (2006). Glossary of Prefabrication, Pre-assembly and Modular Construction. CRC Press.

[17] Gómez Villanueva, S., Ballard, G., Terni, S., Arroyo, P., & Bello, K. (2024). An exploration of psychological safety and team behaviors in a construction global team. In D. B. Costa, F. Drevland, & L. Florez-Perez (Eds.), Proceedings of the 32nd Annual Conference of the International Group for Lean Construction (IGLC 32) (pp. 1111-1122). View Article

[18] Gunduz, M., Alhenzab, F., Al-Hababi, H., & Al-Qahtani, A. (2024). A systematic review of the digital transformation of the building construction industry. IEEE Access, 12, 31461-31487. View Article

[19] Gumusburun Ayalp, G., & Arslan, F. (2025). Modeling critical rework factors in the construction industry: Insights and solutions. Buildings, 15(4), 606. View Article

[20] Gurumayum, S. (2025). Understanding the causes of project delays and cost overruns in construction: A comprehensive analysis across literature, surveys, and case studies. Journal of Civil and Construction Engineering, 11(1), 74-94.

[21] Häringer, S., Gómez, S., & Schöttle, A. (2024). An investigation of psychological safety in construction projects and its influence on team learning behaviour: A survey-based study. In D. B. Costa, F. Drevland, & L. Florez-Perez (Eds.), Proceedings of the 32nd Annual Conference of the International Group for Lean Construction (IGLC 32) (pp. 1123-1134). View Article

[22] Hendrickson, C. (1998). Project Management for Construction: Fundamental Concepts for Owners, Engineers, Architects, and Builders. Prentice Hall.

[23] Hinze, J. (1997). Construction Safety. Prentice Hall.

[24] Ibbs, C. W., Wong, C. K., & Kwak, Y. H. (2001). Project change management system. Journal of Management in Engineering, 17(3), 159-165. View Article

[25] Jin, H., & Peng, Y. (2024). The impact of team psychological safety on employee innovative performance: A study with communication behavior as a mediator variable. PLOS ONE, 19(10), e0306629. View Article

[26] Leung, M. Y., Chan, Y. S., & Yu, J. (2015). Preventing construction worker injury incidents through the management of personal stress and organizational stressors. Accident Analysis & Prevention, 93, 123-135.

[27] Liu, W., Lv, Y., Wang, Q., Sun, B., & Han, D. (2024). A systematic review of the digital twin technology in buildings, landscape, and urban environment from 2018 to 2024. Buildings, 14(11), 3475. View Article

[28] Locke, E. A., & Latham, G. P. (2002). Building a practically useful theory of goal setting and task motivation: A 35-year odyssey. American Psychologist, 57(9), 705-717. View Article

[29] Loosemore, M., Dainty, A., & Lingard, H. (2003). Human Resource Management in Construction Projects: Strategic and Operational Approaches. Spon Press. View Article

[30] Love, P. E. D., Edwards, D. J., Irani, Z., & Walker, J. (2009). Project pathogens: The anatomy of omission errors in construction and resource engineering projects. IEEE Transactions on Engineering Management, 56(3), 425-435. View Article

[31] Mashwama, N., & Thwala, W. (2024). Digital technologies for the reduction of variation orders in construction projects. Proceedings of the Creative Construction Conference 2024. View Article

[32] Mattar, Y., Alzaim, M. A., AlAli, M., Alkhatib, I., & Beheiry, S. (2024). The impact of change orders caused by legislative changes on program management in the UAE construction industry. Buildings, 14(5), 1294. View Article

[33] Meng, X. (2012). The effect of relationship management on project performance in construction. International Journal of Project Management, 30(2), 188-198. View Article

[34] Mintzberg, H. (1983). Structure in Fives: Designing Effective Organizations. Prentice Hall.

[35] Moćan, D. (2025). Designing hybrid organizational models for improving the performance of construction business systems. Ekonomski Vjesnik, 38(1), 29-42. View Article

[36] Moreno, F., Forcael, E., Romo, R., Orozco, F., Moroni, G., & Baesler, F. (2024). Agile project management in the pre-construction stage: Facing the challenges of projectification in the construction industry. Buildings, 14(11), 3551. View Article

[37] Nguyen, T. D. H. N., Ly, D. H., Jang, H., Dinh, H. N. N., & Ahn, Y. (2025). Digital twin framework to enhance facility management for relocatable modular buildings. Automation in Construction, 176, 106249. View Article

[38] Pinto, H. W., Kerzner, R. R., & Cleland, J. D. (2023). Exploring the implementation of agile project management in the United States construction industry: Benefits, challenges, and success factors. Journal of Entrepreneurship & Project Management, 7(7), 11-23. View Article

[39] Revolti, A., Gualtieri, L., Pauwels, P., & Dallasega, P. (2024). From building information modeling to construction digital twin: A conceptual framework. Production & Manufacturing Research, 12(1), 2387679. View Article

[40] Scorgie, D., Feng, Z., Paes, D., Parisi, F., Yiu, T. W., & Lovreglio, R. (2024). Virtual reality for safety training: A systematic literature review and meta-analysis. Safety Science, 171, 106372. View Article

[41] Shi, Y. (2025). Use of digital twin technologies in facility management and related industries: A bibliometric review. Academic Journal of Science and Technology, 14, 91-103. View Article

[42] Smith, R. E. (2010). Prefab Architecture: A Guide to Modular Design and Construction. John Wiley & Sons.

[43] Sobowale, M., Elghaish, F., & Brooks, T. (2023). A systematic review of digital twin as a predictive maintenance approach for existing buildings in the UK. In Proceedings of the 23rd International Conference on Construction Applications of Virtual Reality (CONVR 2023) (pp. 1206-1218). View Article

[44] Stefan, H., Mortimer, M., & Horan, B. (2023). Evaluating the effectiveness of virtual reality for safety-relevant training: A systematic review. Virtual Reality, 27(4), 2839-2869. View Article

[45] Turner, J. R. (2009). The Handbook of Project-Based Management: Leading Strategic Change in Organizations. McGraw-Hill Education.

[46] Walker, A. (2015). Project Management in Construction. John Wiley & Sons.
